On site now

C13-1 Micropile: Drilling Complete, Depth Confirmed At Ctl-43.20m, Rebar Cage Installation, Water Flushing And Grouting Complete in Marine Parade

Job 22PS 29 Jul – 25 Oct 2026 13 updates 37 photos Marine Parade

These are working photos from an active Larry Contractors renovation, updated as the job moves. For finished work, see the portfolio.

25 Oct 3 days ago 4 photos

S9-1 depth confirmed at CTL-43.20m, rebar cage installation started, then water flushing and grouting started.

C13-1 Micropile: Drilling Complete, Depth Confirmed At Ctl-43.20m, Rebar Cage Installation, Water Flushing And Grouting Complete in Marine Parade — Larry Contractors job 22PS, 25 Oct, photo 1C13-1 Micropile: Drilling Complete, Depth Confirmed At Ctl-43.20m, Rebar Cage Installation, Water Flushing And Grouting Complete in Marine Parade — Larry Contractors job 22PS, 25 Oct, photo 2C13-1 Micropile: Drilling Complete, Depth Confirmed At Ctl-43.20m, Rebar Cage Installation, Water Flushing And Grouting Complete in Marine Parade — Larry Contractors job 22PS, 25 Oct, photo 3C13-1 Micropile: Drilling Complete, Depth Confirmed At Ctl-43.20m, Rebar Cage Installation, Water Flushing And Grouting Complete in Marine Parade — Larry Contractors job 22PS, 25 Oct, photo 4
23 Oct 6 days ago 4 photos

S9-2 drilled and depth confirmed, rods dismantled, then water flushing and grouting complete.

C13-1 Micropile: Drilling Complete, Depth Confirmed At Ctl-43.20m, Rebar Cage Installation, Water Flushing And Grouting Complete in Marine Parade — Larry Contractors job 22PS, 23 Oct, photo 1C13-1 Micropile: Drilling Complete, Depth Confirmed At Ctl-43.20m, Rebar Cage Installation, Water Flushing And Grouting Complete in Marine Parade — Larry Contractors job 22PS, 23 Oct, photo 2C13-1 Micropile: Drilling Complete, Depth Confirmed At Ctl-43.20m, Rebar Cage Installation, Water Flushing And Grouting Complete in Marine Parade — Larry Contractors job 22PS, 23 Oct, photo 3C13-1 Micropile: Drilling Complete, Depth Confirmed At Ctl-43.20m, Rebar Cage Installation, Water Flushing And Grouting Complete in Marine Parade — Larry Contractors job 22PS, 23 Oct, photo 4
22 Oct 7 days ago 3 photos

S9-2 drilling work started. Pile heads exposed in the excavated pit.

C13-1 Micropile: Drilling Complete, Depth Confirmed At Ctl-43.20m, Rebar Cage Installation, Water Flushing And Grouting Complete in Marine Parade — Larry Contractors job 22PS, 22 Oct, photo 1C13-1 Micropile: Drilling Complete, Depth Confirmed At Ctl-43.20m, Rebar Cage Installation, Water Flushing And Grouting Complete in Marine Parade — Larry Contractors job 22PS, 22 Oct, photo 2C13-1 Micropile: Drilling Complete, Depth Confirmed At Ctl-43.20m, Rebar Cage Installation, Water Flushing And Grouting Complete in Marine Parade — Larry Contractors job 22PS, 22 Oct, photo 3
21 Oct 8 days ago 4 photos

C13-1 micropile: drilling complete, depth confirmed at CTL-43.20m, rebar cage installation, water flushing and grouting complete.

C13-1 Micropile: Drilling Complete, Depth Confirmed At Ctl-43.20m, Rebar Cage Installation, Water Flushing And Grouting Complete in Marine Parade — Larry Contractors job 22PS, 21 Oct, photo 1C13-1 Micropile: Drilling Complete, Depth Confirmed At Ctl-43.20m, Rebar Cage Installation, Water Flushing And Grouting Complete in Marine Parade — Larry Contractors job 22PS, 21 Oct, photo 2C13-1 Micropile: Drilling Complete, Depth Confirmed At Ctl-43.20m, Rebar Cage Installation, Water Flushing And Grouting Complete in Marine Parade — Larry Contractors job 22PS, 21 Oct, photo 3C13-1 Micropile: Drilling Complete, Depth Confirmed At Ctl-43.20m, Rebar Cage Installation, Water Flushing And Grouting Complete in Marine Parade — Larry Contractors job 22PS, 21 Oct, photo 4
19 Oct 10 days ago 3 photos

22PS — C13-2 under way: casing installation started with the rig checked level, then Dia 300 drilling began.

C13-1 Micropile: Drilling Complete, Depth Confirmed At Ctl-43.20m, Rebar Cage Installation, Water Flushing And Grouting Complete in Marine Parade — Larry Contractors job 22PS, 19 Oct, photo 1C13-1 Micropile: Drilling Complete, Depth Confirmed At Ctl-43.20m, Rebar Cage Installation, Water Flushing And Grouting Complete in Marine Parade — Larry Contractors job 22PS, 19 Oct, photo 2C13-1 Micropile: Drilling Complete, Depth Confirmed At Ctl-43.20m, Rebar Cage Installation, Water Flushing And Grouting Complete in Marine Parade — Larry Contractors job 22PS, 19 Oct, photo 3
6 Oct 6 Oct 2026 2 photos

We are configuring the lift pit and position of underground beam connection while the piling is happening.

C13-1 Micropile: Drilling Complete, Depth Confirmed At Ctl-43.20m, Rebar Cage Installation, Water Flushing And Grouting Complete in Marine Parade — Larry Contractors job 22PS, 6 Oct, photo 1C13-1 Micropile: Drilling Complete, Depth Confirmed At Ctl-43.20m, Rebar Cage Installation, Water Flushing And Grouting Complete in Marine Parade — Larry Contractors job 22PS, 6 Oct, photo 2
15 Sep 15 Sep 2026 3 photos

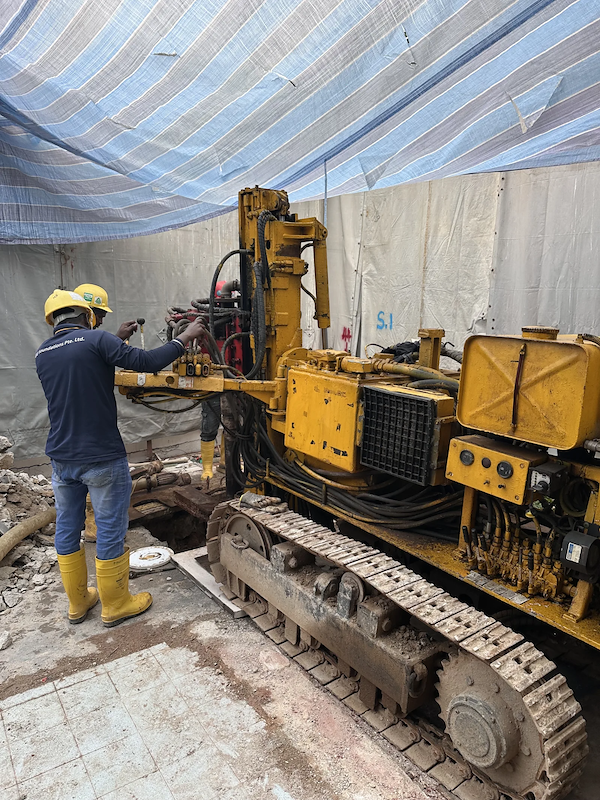

Piling has started at 22PS. The job is 30 piles and 17 columns. We put a tarpaulin canopy over the rig so the team can work in the shade. The mixing and pumping equipment is set up in the front yard.

C13-1 Micropile: Drilling Complete, Depth Confirmed At Ctl-43.20m, Rebar Cage Installation, Water Flushing And Grouting Complete in Marine Parade — Larry Contractors job 22PS, 15 Sep, photo 1C13-1 Micropile: Drilling Complete, Depth Confirmed At Ctl-43.20m, Rebar Cage Installation, Water Flushing And Grouting Complete in Marine Parade — Larry Contractors job 22PS, 15 Sep, photo 2C13-1 Micropile: Drilling Complete, Depth Confirmed At Ctl-43.20m, Rebar Cage Installation, Water Flushing And Grouting Complete in Marine Parade — Larry Contractors job 22PS, 15 Sep, photo 3
6 Sep 6 Sep 2026 2 photos

Setting out at 22PS before piling starts. The surveyor is taking levels on site and again from the road at the front boundary. Noise barrier sheeting is up around the perimeter. Piling starts next week.

C13-1 Micropile: Drilling Complete, Depth Confirmed At Ctl-43.20m, Rebar Cage Installation, Water Flushing And Grouting Complete in Marine Parade — Larry Contractors job 22PS, 6 Sep, photo 1C13-1 Micropile: Drilling Complete, Depth Confirmed At Ctl-43.20m, Rebar Cage Installation, Water Flushing And Grouting Complete in Marine Parade — Larry Contractors job 22PS, 6 Sep, photo 2
13 Aug 13 Aug 2026 1 photo

Reconstruct job in progress. Before we take anything down we work out what can be removed and how to remove it safely. We do it slowly so the debris stays on our side and does not fly across to the neighbours. Scaffold up, walls opened, brick cleared as we go.

C13-1 Micropile: Drilling Complete, Depth Confirmed At Ctl-43.20m, Rebar Cage Installation, Water Flushing And Grouting Complete in Marine Parade — Larry Contractors job 22PS, 13 Aug, photo 1
13 Aug 13 Aug 2026 3 photos

Demolition and strip-out on job 22PS, getting the site ready for piling works. Roof covering came off to expose the timber and the structure, and the internal walls were taken down. Not a straightforward demolition. A lot of hurdles to solve before we could clear the ground.

C13-1 Micropile: Drilling Complete, Depth Confirmed At Ctl-43.20m, Rebar Cage Installation, Water Flushing And Grouting Complete in Marine Parade — Larry Contractors job 22PS, 13 Aug, photo 1C13-1 Micropile: Drilling Complete, Depth Confirmed At Ctl-43.20m, Rebar Cage Installation, Water Flushing And Grouting Complete in Marine Parade — Larry Contractors job 22PS, 13 Aug, photo 2C13-1 Micropile: Drilling Complete, Depth Confirmed At Ctl-43.20m, Rebar Cage Installation, Water Flushing And Grouting Complete in Marine Parade — Larry Contractors job 22PS, 13 Aug, photo 3
8 Aug 8 Aug 2026 2 photos

This is the demolition stage of a landed reconstruction. We run skid tanks in and out to cart away the debris, usually eight to fifteen loads over the demolition. A noise monitoring device is set up on the hoarding to keep track of levels while we work.

C13-1 Micropile: Drilling Complete, Depth Confirmed At Ctl-43.20m, Rebar Cage Installation, Water Flushing And Grouting Complete in Marine Parade — Larry Contractors job 22PS, 8 Aug, photo 1C13-1 Micropile: Drilling Complete, Depth Confirmed At Ctl-43.20m, Rebar Cage Installation, Water Flushing And Grouting Complete in Marine Parade — Larry Contractors job 22PS, 8 Aug, photo 2
4 Aug 4 Aug 2026 4 photos

Internal demolition underway on this job. We are stripping the interior back and hauling the rubble out by skid tank, lost count of how many we have filled. Next step is the external wall once the inside is cleared.

C13-1 Micropile: Drilling Complete, Depth Confirmed At Ctl-43.20m, Rebar Cage Installation, Water Flushing And Grouting Complete in Marine Parade — Larry Contractors job 22PS, 4 Aug, photo 1C13-1 Micropile: Drilling Complete, Depth Confirmed At Ctl-43.20m, Rebar Cage Installation, Water Flushing And Grouting Complete in Marine Parade — Larry Contractors job 22PS, 4 Aug, photo 2C13-1 Micropile: Drilling Complete, Depth Confirmed At Ctl-43.20m, Rebar Cage Installation, Water Flushing And Grouting Complete in Marine Parade — Larry Contractors job 22PS, 4 Aug, photo 3C13-1 Micropile: Drilling Complete, Depth Confirmed At Ctl-43.20m, Rebar Cage Installation, Water Flushing And Grouting Complete in Marine Parade — Larry Contractors job 22PS, 4 Aug, photo 4
29 Jul 29 Jul 2026 2 photos

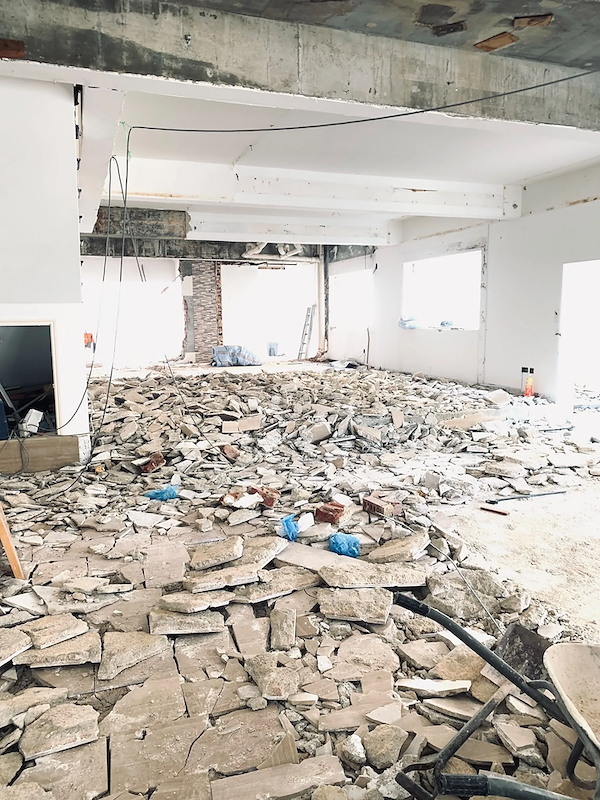

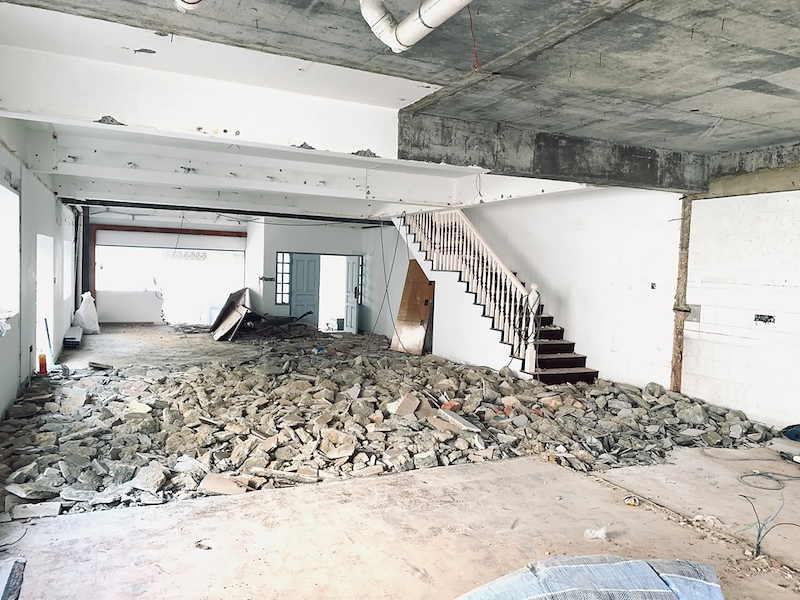

Site checked and cleared ahead of piling works. Floor slab has been broken out and the space stripped back to the bare structure. Beams, columns and the existing staircase are exposed so we can see what we are working with. Next step is preparing the ground for the piling.

C13-1 Micropile: Drilling Complete, Depth Confirmed At Ctl-43.20m, Rebar Cage Installation, Water Flushing And Grouting Complete in Marine Parade — Larry Contractors job 22PS, 29 Jul, photo 1C13-1 Micropile: Drilling Complete, Depth Confirmed At Ctl-43.20m, Rebar Cage Installation, Water Flushing And Grouting Complete in Marine Parade — Larry Contractors job 22PS, 29 Jul, photo 2
